Availability: Accounts with the Premier or Enterprise plan
Key info: Planned and spent department budgets, along with the time taken to fill requisitions
Default date filter: Requisition plan date. Learn more about report date filters.
Update frequency: Every 2 hours
To access the Hiring performance report, go to the Reports page in the navigation bar and open Hiring performance.
Refine the data by filtering the results by job, department, requisition location, hiring manager, requisition owner, status, or date.
The department filter defaults to top-level departments. Use it to review requisition performance in sub-departments. Department totals include requisitions from their sub-departments.
Visual data

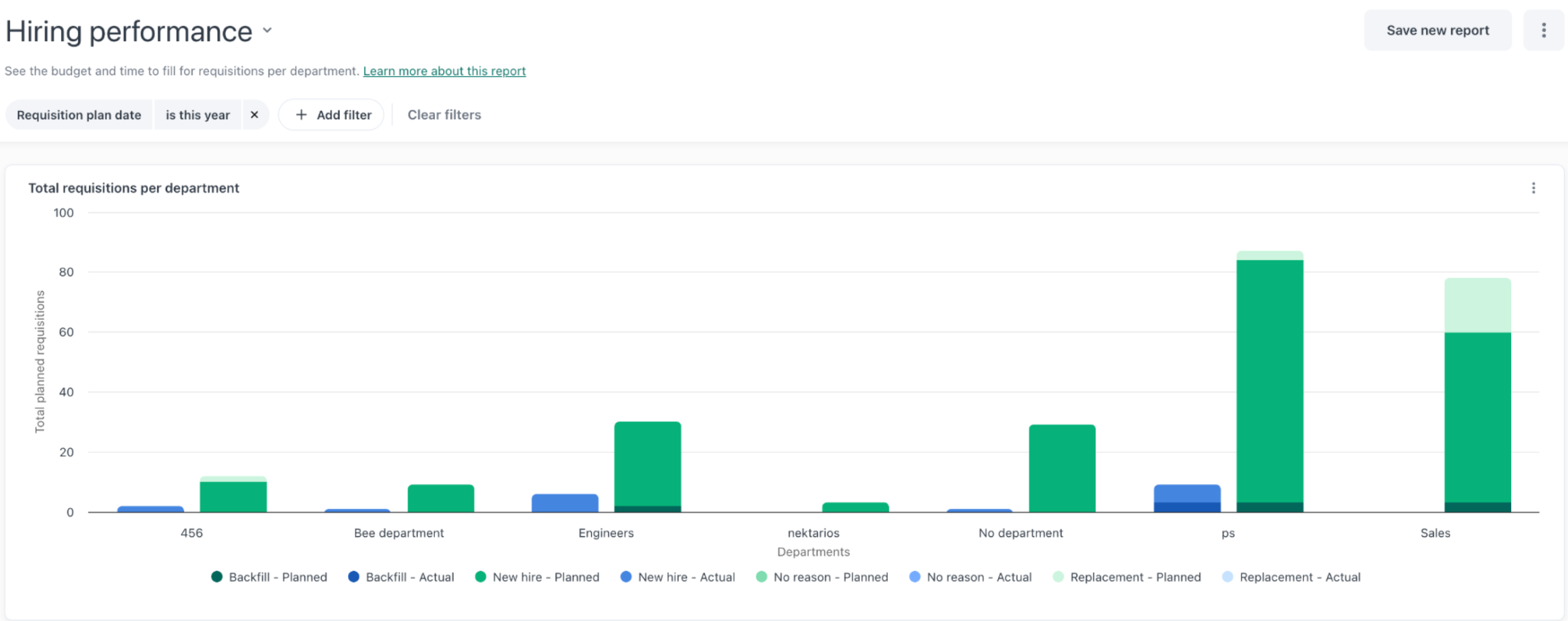

The Hiring performance chart compares planned and filled requisitions for each department. Use the legend to identify each series.
The colored bar segments represent the number of new hires, replacements, and backfills.
Note: The chart is generated only when the Reason field is enabled and completed for requisitions.
Select a colored bar segment to open the requisitions behind it. Department totals include requisitions from their sub-departments.
Tabular data

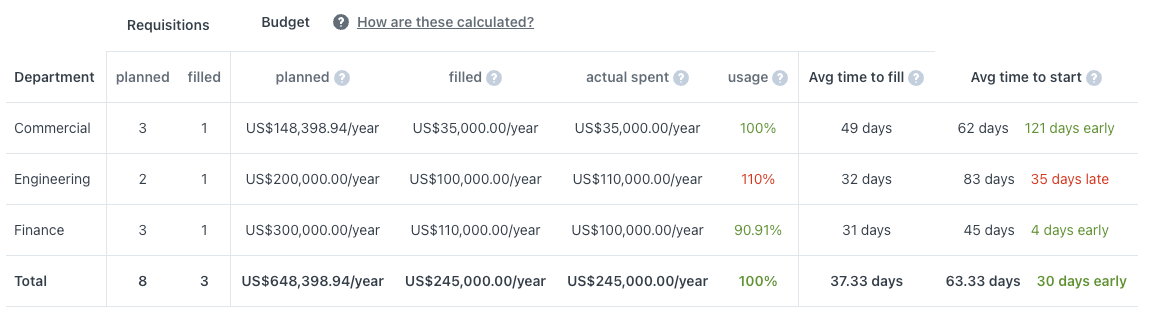

The table provides more detail about budgets and the time taken to fill requisitions in each department.
Totals use the most common currency among the requisitions currently displayed. Salaries in other currencies are converted to your account's common currency.
Pay that is not expressed as an annual salary is converted to annual pay. For example, an offer of $20 per hour is annualized using: hourly pay rate × hours per week × weeks per year.

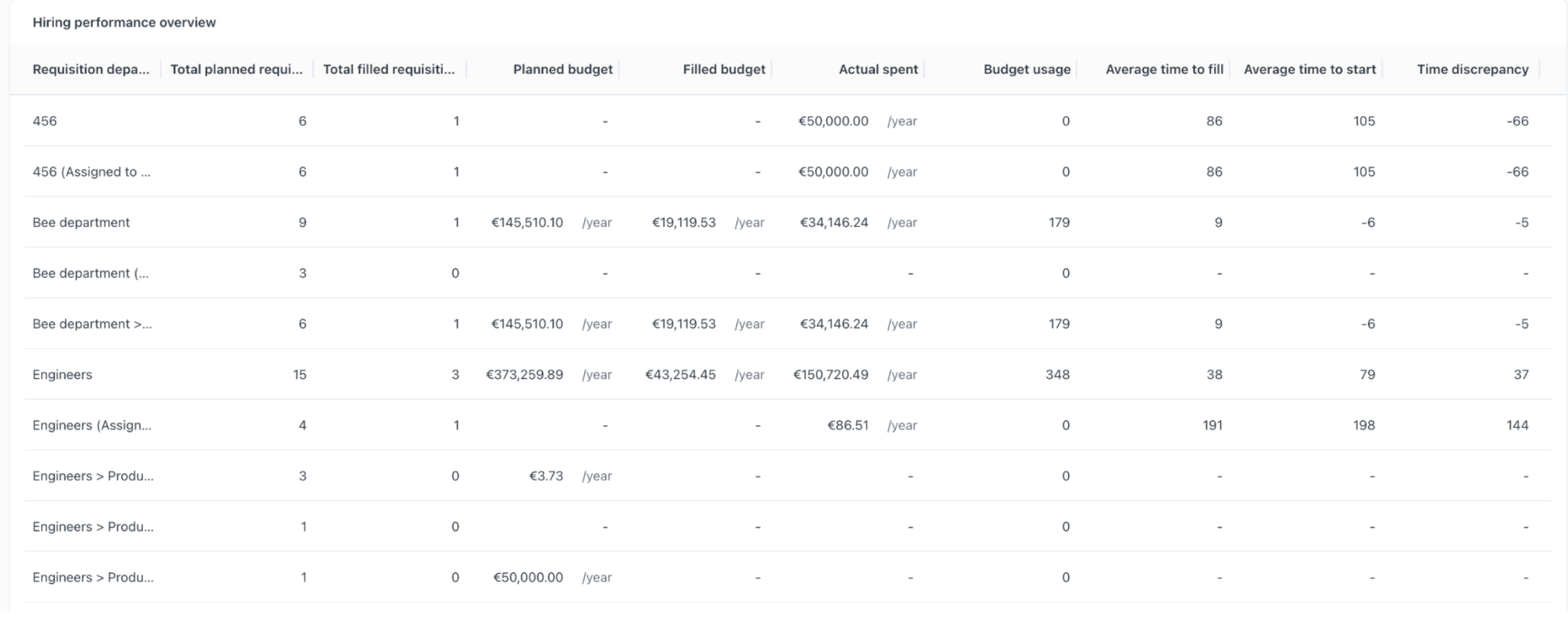

Select a Total planned or Total filled count to open the matching requisitions. Department totals include requisitions from their sub-departments.
Planned budget: The sum of planned salaries for the department's requisitions.
Filled budget: The sum of planned salaries for requisitions that have been filled, regardless of the salaries actually offered.
Actual spent: The sum of salaries actually offered to candidates when the requisitions were filled.

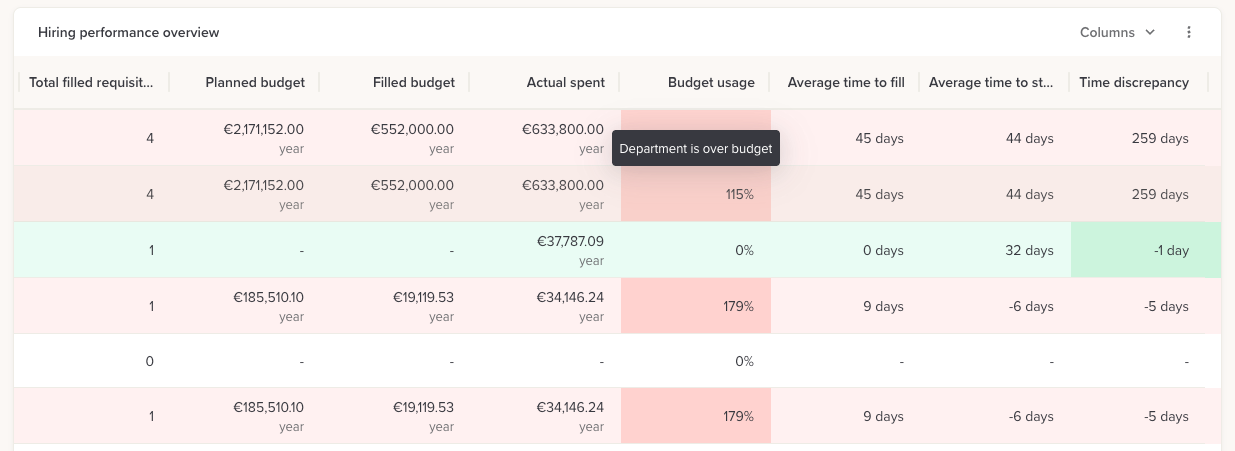

Budget usage: Actual spent divided by Filled budget, expressed as a percentage. Above 100% means the team is over budget for the jobs filled so far. Below 100% means it is within the planned budget.
For example, if Finance requisitions have a filled budget of $110,000 and actual offered salaries total $100,000, budget usage is 90.91%, indicating that the department is under budget.
Average time to fill: Average time from requisition opening to the candidate being moved to Hired. Time when a requisition was on hold is excluded from this calculation.
Average time to start: Average time from requisition opening to the hired candidate's start date at your company.
Time discrepancy: Average number of days between candidates' start dates and the requisition plan date. The plan date is always the last day of the selected month. When filtering by a custom date range, include the last day of the month.
Departments where hires started ahead of schedule are highlighted green. Departments above the targeted budget usage are highlighted red.
Viewing the requisitions behind a count
Select a chart segment or a Total planned or Total filled count to open a details view with the matching requisitions.
Applied report filters and the selected value appear as filter chips. Select a chip containing multiple values to see the full list.
By default, the details view includes:
- Requisition code
- Job title
- Requisition department
- Requisition status
- Requisition reason
- Budgeted salary
- Offered salary
- Plan date
Use Columns to add or remove columns, select a column heading to sort, and move between pages to review more requisitions.
Exporting requisition details
If you have permission to export reports, select Download CSV to receive the displayed table by email. The export includes the columns and sort order currently shown.
Access permissions
The details view respects your access permissions, so you may see fewer records than those represented by a count in a shared report.
